Global highway construction is shifting toward large-scale, multi-section, and cross-regional coordination. Over the next decade, global infrastructure investment demand is expected to exceed 151 trillion USD, with transportation infrastructure as a key focus. The Asia-Pacific region accounts for about 45% of global road construction activity. As EPC contracting and multi-section construction increase, asphalt mixing plants have evolved from production units into key supply nodes for continuous construction. Traditional decentralized supply can no longer meet demands for quality, efficiency, and cost control. Therefore, centralized asphalt supply systems based on large asphalt mixing plants—featuring centralized production, unified supply, and digital scheduling—are becoming a global trend in highway projects.

| Supply Model | Structural Characteristics | Advantages | Challenges | Applicable Scenarios |
|---|---|---|---|---|
| Decentralized Supply | Independent asphalt plants for each section | Flexible, fast startup | Inconsistent quality, high cost | Small-scale projects |
| Regional Centralized Supply | One regional asphalt plant serves multiple sections | Lower overall cost | Longer transportation distance | Medium-scale highway projects |
| Centralized Unified Supply (Mainstream) | 1–2 large asphalt plants + multi-section delivery | Consistent quality, high efficiency | Complex early-stage planning | Large cross-regional highway projects |
| Hybrid Model (Emerging Trend) | Central asphalt plant + mobile asphalt plants for supplementation | Balances flexibility and stability | High system requirements | Ultra-large EPC projects |
Background of Multi-Section Highway Projects and Asphalt Supply Challenges
Driven by growing global infrastructure investment, highway construction is shifting toward multi-section and cross-regional coordination. Annual transport infrastructure investment has exceeded $3.5–3.8 trillion. EPC contracting is widely used in large projects, driving a shift from single-section work to a network-based system. In this context, asphalt mixing plants and their supply systems have become key nodes for multi-section project stability. This chapter reviews global multi-section highway projects, focusing on structure, supply chain complexity, and mismatches in quality and construction rhythm, and lays the foundation for a unified asphalt supply system.

Global Infrastructure Expansion and Growth of Multi-Section Highway Projects
Global highway and infrastructure construction is entering a new expansion cycle, with increasing project scale and complexity.
🌍 Key Global Infrastructure and Road Construction Data (2024–2026)
| Indicator | Global Level | Key Trend |
|---|---|---|
| Global infrastructure investment | > $3.5–3.8 trillion/year | Continuous growth |
| Transportation infrastructure share | 35–45% | Long-term core sector |
| Asia-Pacific market share | ≈ 45% | Main driver of highway construction |
| Middle East & Africa growth rate | 6–9% CAGR | Rapid expansion stage |
| EPC adoption in large projects | 60%+ | Mainstream delivery model |
🏗 Structural Characteristics of Multi-Section Highway Projects
Modern highway projects show clear structural transformation:
- 📏 Project length: 50–500 km cross-regional corridors.
- 🧩 Section scale: 3–15 independent construction sections.
- 🏢 Parallel execution by multiple contractors.
- ⏱ Construction period: 20–40% schedule compression.
- 🚧 Multi-front simultaneous construction (network-based execution).
👉 Core shift: from linear construction to a network-based coordination system.

Complexity of Asphalt Supply Chains in Cross-Regional Construction
As project scale increases, asphalt supply evolves from a single-point production model into a multi-node coordination system covering production, transport, and construction.
🏭 Global Asphalt Supply Chain Structure
| Segment | Function | Key Equipment/Resources | System Feature |
|---|---|---|---|
| Raw material supply | Aggregates, asphalt, additives | Quarry and oil supply chains | High volatility |
| Production stage | Asphalt mixture production | Asphalt mixing plant | Core control node |
| Transport system | Material delivery | Insulated transport fleet | Time-sensitive |
| Construction site | Paving operation | Pavers and rollers | Highly dynamic rhythm |
🚚 Key Transport Parameters in Cross-Regional Projects
| Parameter | Typical Range | Impact |
|---|---|---|
| Average transport distance | 10–60 km | Cost and temperature loss |
| Asphalt temperature loss | 5–25°C | Compacts quality risk |
| Waiting time | 10–45 min | Lower equipment utilization |
| Empty return rate | 8–18% | Higher logistics cost |
| Daily supply fluctuation | ±15–30% | Construction interruption risk |
🔄 System Complexity Shift
The asphalt supply chain is evolving from a linear process into a dynamic multi-variable scheduling system.
Key variables include:
- Climate and environmental changes.
- Section-level construction progress differences.
- Mixing plant capacity fluctuations.
- Transport scheduling efficiency.
- Raw material supply stability.
Quality Consistency and Construction Rhythm Imbalance
In multi-section highway projects, the core contradiction lies in the mismatch between quality consistency control and synchronized construction rhythm.
Asphalt Mixture Quality Variation
| Factor | Variation Range | Engineering Impact |
|---|---|---|
| Mix ratio control | ±1–3% | Reduced pavement performance |
| Discharge temperature | ±10–25°C | Unstable compaction density |
| Aggregate gradation | Medium variation | Uneven strength |
| Automation level | Low to high | Increased human error |
👉 Result:
Pavement service life difference: 15–30%.
Rework rate increase: 5–12%.
Difficulty in standardizing quality consistency.
Construction Rhythm Imbalance in Multi-Section Projects
Multi-section highway construction often shows asynchronous execution patterns:
- 🔵 Section A: peak paving stage.
- 🟡 Section B: material preparation stage.
- 🟢 Section C: intermittent construction stage.
- 🔴 Section D: accelerated construction stage.
📊 Three Core Rhythm Mismatch Systems
| System | Definition | Main Issue | Result |
|---|---|---|---|
| Production rhythm | Stable output from mixing plant | Idle or overload capacity | Lower utilization |
| Transport rhythm | Vehicle circulation and dispatching | Queueing, delays, empty return | Higher cost |
| Construction rhythm | Multi-section dynamic execution | Lack of synchronization | Material shortage or backlog |
🔗 Systemic Imbalance Effects
When the three rhythms are not aligned, a chain reaction occurs:
The supply challenges in global multi-section highway projects are essentially a systemic conflict between: “Decentralized construction structures” and “centralized quality and supply control systems.”
Core Pain Points of Multi-Section Asphalt Supply
In global multi-section highway projects, asphalt supply is shifting from a traditional single-plant delivery model to a cross-regional, multi-node coordination system. With the rise of EPC contracting and large transport corridor development, supply systems have become more complex. Problems now extend across production, transportation, and construction stages.

Quality Fluctuation and Inconsistent Mix Design Caused by Decentralized Supply
In multi-section construction, asphalt mixing plants are often operated by different contractors or regional sites, with limited unified control standards.
🌍 Typical Quality Variation in Global Projects
- Asphalt mix design deviation: ±2%–5%
- Discharge temperature fluctuation: ±10–25°C
- Aggregate gradation inconsistency: medium to high risk
- Significant reduction in material consistency across sections
⚠ Engineering Impacts
- Uneven pavement compaction
- Increased structural performance differences
- Higher risk of early pavement damage (cracking, rutting)
- Road lifespan differences of up to 15–30% between sections
- 👉 Core issue: decentralized supply cannot form a unified quality control loop.
Temperature Loss and Material Waste Caused by Long-Distance Transport
In cross-regional projects, asphalt mixtures are transported via insulated trucks, but unstable transport distances become a key quality factor.
🚚 Key Global Transport Data
- Typical transport distance: 10–60 km.
- Temperature loss: 5–25°C.
- Material loss rate: 6–12% (decentralized model).
- Empty return rate: 10–18%.
📊 Transport Distance vs Quality Impact
| Distance | Temperature Loss | Risk Level |
|---|---|---|
| 10–20 km | 5–10°C | Low |
| 20–40 km | 10–18°C | Medium |
| 40–60 km | 18–25°C | High |
| >60 km | >25°C | Very High |
Key Engineering Issues
- Premature cooling reduces compaction quality.
- Material performance loss becomes irreversible.
- Complex logistics reduce dispatch efficiency.
- Costs increase non-linearly with distance.
👉 Core issue: transport distance has become a critical quality control variable.
Coordination Difficulties and Scheduling Conflicts Among Multiple Contractors
Multi-section projects involve multiple contractors working simultaneously, which requires the supply system to serve several independent decision-making units.
🏗 Typical Coordination Structure
3–10+ contractors involved.
Parallel or overlapping construction sections.
Independent scheduling systems.
No unified supply control center.
⚠ Typical Scheduling Conflicts
Multiple sections competing for materials and causing queues.
Conflicting production plans at asphalt mixing plants.
Disorganized vehicle dispatching.
Delayed response to urgent construction acceleration.
📉 System Efficiency Loss (Industry Range)
Equipment utilization drops by 15–35%.
Waiting time increases by 10–45 minutes per trip.
Empty return rates increase significantly.
Uneven material supply across sections.
👉 Core issue: lack of centralized scheduling leads to fragmented operations.
Construction Stagnation Risk Caused by Capacity Imbalance
Another key challenge is the mismatch between highly fluctuating demand and fixed production capacity.

📈 Demand Pattern in Multi-Section Projects
Early stage: low load operation.
Peak stage: sudden demand surge.
Final stage: rapid decline.
⚠ Capacity Mismatch Problems
Fixed output cannot match dynamic demand.
Bottlenecks occur during peak construction periods.
Severe equipment idle time during low demand stages.
📊 Impact of Capacity Imbalance
Average equipment utilization: 60–80%.
Shutdown risk increases during peak periods.
Resource waste rate: 10–20%.
Delay risk increases with number of sections.
👉 Core issue: fixed-capacity systems cannot fit dynamic multi-section networks
The core contradictions in multi-section asphalt supply systems are concentrated in four areas: quality fluctuation, transport loss, scheduling conflicts, and capacity imbalance. The root cause is clear: A decentralized supply model cannot match a network-based multi-section construction structure.
The Optimal Asphalt Supply Model for Multi-Section Highway Projects
In multi-section highway projects, the core shift in asphalt supply is from decentralized, single-point delivery to a system-based centralized scheduling model. A Unified Asphalt Supply System focuses on centralized production, unified quality control, and multi-section coverage. It enables efficient coordination across cross-regional construction.

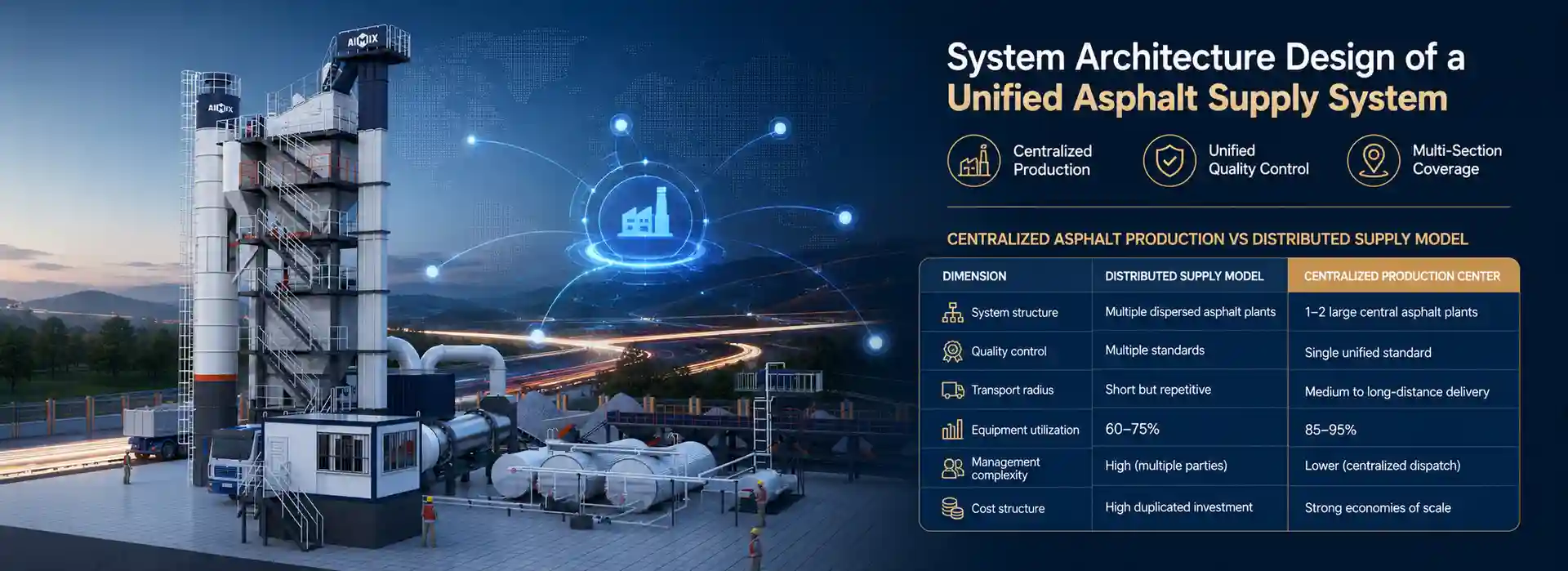

Centralized Asphalt Production vs Distributed Supply Model
In global engineering practice, both models exist, but their efficiency and application scenarios differ significantly.

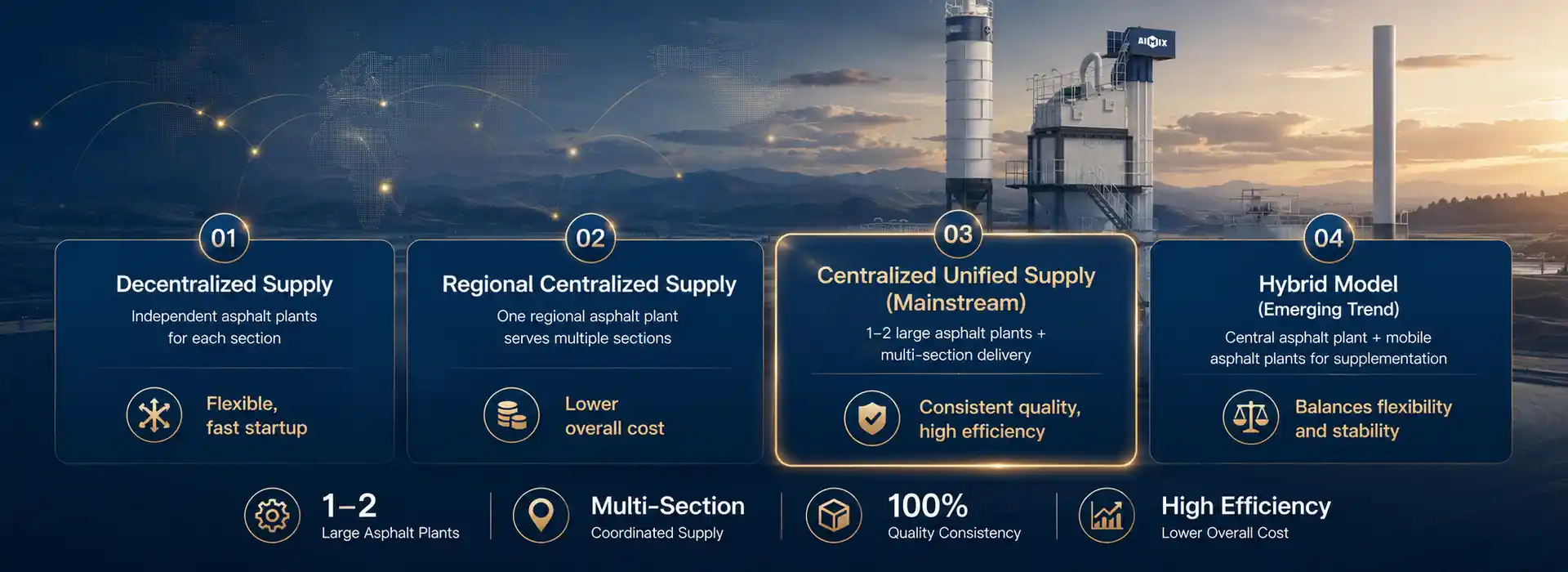

🌍 Comparison of Main Supply Models
| Dimension | Distributed Supply Model | Centralized Production Center |
|---|---|---|
| System structure | Multiple dispersed asphalt plants | 1–2 large central asphalt plants |
| Quality control | Multiple standards | Single unified standard |
| Transport radius | Short but repetitive | Medium to long-distance delivery |
| Equipment utilization | 60–75% | 85–95% |
| Management complexity | High (multiple parties) | Lower (centralized dispatch) |
| Cost structure | High duplicated investment | Strong economies of scale |
📌 Key Engineering Findings: Distributed model fits small or low-complexity projects, and Centralized model becomes the mainstream for large multi-section highways.
👉 Core trend: global highway projects are shifting from “equipment dispersion” to “production centralization + system coordination”
System Design of “Central Plant + Multi-Section Coverage”
The core of a unified asphalt supply system is a network structure based on centralized production and multi-point distribution.
🏗 Overall System Architecture
Core components:
🏭 Central Asphalt Mixing Plant.
🚛 Intelligent transport and dispatch system.
🧩 Multi-section construction network.
📡 Data monitoring and control platform.
🔷 System Operation Logic
The central asphalt plant produces standardized asphalt mixtures.
Production is scheduled based on real-time demand.
Transport follows optimized routing plans.
Each section receives materials according to its construction rhythm.
The data system continuously updates supply-demand balance.
📊 Performance Improvements of Centralized System
- Quality consistency: ↑ 30–50% (more stable mix quality).
- Equipment utilization: ↑ 20–35% (less idle time).
- Transport efficiency: ↑ 15–25% (better logistics coordination).
- Cost control: ↓ 10–25% (reduced waste and optimized resources).
- Construction continuity: significantly improved (fewer interruptions).
A unified supply system is built on three pillars: entralized production + network-based delivery + dynamic scheduling.
Capacity Planning and Section Demand Matching Model
The success of a unified asphalt supply system depends on how accurately capacity matches multi-section demand.
📈 Demand Characteristics in Global Multi-Section Projects
3–15 construction sections.
Daily demand fluctuation: ±20–40%.
Peak demand concentrated in construction windows.
Strong seasonal effects (rainy or winter periods).
🧮 Basic Capacity Planning Model
Required capacity (TPH) = Total demand (t/day) ÷ Effective working hours (h)
Adjustment factors:
🔺 Peak factor: 1.2–1.5.
🔺 Transport loss compensation: 3–8%.
🔺 Equipment redundancy: 10–20%.

📊 Capacity Matching Strategy Matrix
| Project Scale | Recommended Setup | Capacity Configuration |
|---|---|---|
| Small (<100 km) | Single central asphalt plant | 40–160 TPH |
| Medium (100–300 km) | Dual central asphalt plants | 160–240 TPH |
| Large (300 km+) | Multi-plant + mobile asphalt plant units | 240–320+ TPH |
🚧 Common Configuration Strategy
Main Asphalt plant: stable base supply.
Auxiliary plant: peak demand support.
Mobile Asphalt plant: remote section coverage.
⚠ Key Engineering Risks (If Mismatch Occurs)
Supply bottlenecks during peak periods
Long-term low equipment utilization
Uneven supply across sections
Increased risk of project delays
The architecture of a unified asphalt supply system can be defined as: A system centered on a central asphalt mixing plant, supported by multi-section network coverage and intelligent scheduling, enabling dynamic matching between capacity and demand.
Asphalt Plant Selection and Capacity Configuration Strategy
In multi-section highway projects, asphalt mixing plant selection is no longer a simple equipment decision. It becomes a system-level configuration problem based on capacity, transport radius, construction rhythm, and redundancy planning. Large global infrastructure projects often use a multi-layer setup: main asphalt plant for centralized supply, auxiliary plants for support, and mobile asphalt plants for coverage to ensure stable, efficient, and continuous asphalt supply.

Large Fixed Asphalt Plants: High-Capacity Central Supply System
Large fixed asphalt mixing plants serve as the core production unit in a unified supply system. They mainly support continuous supply for main highway sections.
🏗 Global Application Features
Capacity range: 160–320+ TPH
Operation mode: 24-hour or long-cycle continuous production
Service radius: 30–80 km
Typical use: main sections of cross-regional highway projects
📌 Key Advantages
High production stability for large-scale continuous paving
Automated batching system ensures mix consistency
Centralized quality control reduces variation
Fully supports EPC general contracting management
⚠ Engineering Limitations
Longer construction and installation period
Higher site selection requirements
Strong dependence on transport system efficiency
👉 Core role definition: A high-capacity, high-stability centralized production hub.
Mobile Asphalt Plants: Flexible Supplement and Regional Coverage System
Mobile asphalt mixing plants mainly provide flexible support and short-distance coverage in multi-section projects. They are especially suitable for complex terrain and scattered construction zones.

🚛 Global Application Scenarios
Capacity range: 60–120 TPH
Deployment time: 7–20 days
Service radius: 10–30 km
Typical areas: mountainous regions, remote sections, temporary works.
📌 Core Value
Fast deployment improves responsiveness.
Shortens transport distance and reduces temperature loss.
Improves continuity in local construction.
Acts as a capacity supplement to main asphalt mix plants.
⚠ Engineering Limitations
Limited single-unit capacity.
Not suitable as a primary supply center.
Higher long-term operating cost in some cases.
👉 System role definition: A flexible supplement and regional coverage nod.
Capacity (TPH) and Construction Demand Matching Model
In multi-section projects, capacity design is not about “the bigger, the better.” It must match construction rhythm precisely.
🧮 Basic Capacity Formula: Required capacity (TPH) = Daily asphalt demand (tons) ÷ Effective working hours (h).
📊 Capacity Configuration Reference Model
| Project Scale | Daily Demand | Recommended Capacity | System Setup |
|---|---|---|---|
| Small (<100 km) | 800–1500 t/day | 80–160 TPH | Single-plant system |
| Medium (100–300 km) | 1500–3000 t/day | 160–240 TPH | Dual-plant system |
| Large (300 km+) | 3000–6000+ t/day | 240–320+ TPH | Multi-plant + mobile asphalt plant units |
⚠ Key Adjustment Factors
Peak factor: 1.2–1.5
Transport loss compensation: 3–8%
Equipment redundancy factor: 10–20%
👉 Core logic: Capacity design must cover average demand + peak fluctuations + system redundancy.
Multi-Plant Parallel Operation and Redundancy Strategy
In large global highway projects, a single asphalt plant cannot ensure stable operation. Therefore, multi-plant parallel systems are widely used.
🏗 Parallel System Structure
🏭 Main asphalt plant (core production).
🏭 Auxiliary plant (peak support).
🚛 Mobile asphalt plant (regional coverage).
📡 Dispatch center (unified control system).
📊 Comparison of Multi-Plant Systems
| System Type | Stability | Flexibility | Cost Efficiency | Applicable Projects |
|---|---|---|---|---|
| Single Asphalt plant | Medium | Low | High | Small projects |
| Dual Asphalt plants | High | Medium | Relatively good | Medium projects |
| Multi + mobile asphalt plants | Very high | High | Best (long-term) | Large EPC projects |
⚠ Role of Redundancy Design
Prevent full shutdown caused by single asphalt plant failure.
Handle peak construction demand.
Improve system fault tolerance.
Ensure continuous multi-section construction.
👉 Core system value: From equipment selection to engineering system stability design.
The core logic of asphalt plant selection is not equipment specification. It is: A system-based configuration design driven by capacity matching and multi-section construction demand.
Unified Dispatch and Digital Supply Management System
In multi-section highway projects, asphalt supply is no longer managed by manual coordination alone. It increasingly relies on a digital, system-based dispatch platform that connects production, transport, and construction in real time.
Production Planning and Construction Schedule Coordination
A unified system links asphalt production plans directly with construction progress. This ensures supply matches real project demand.
🔄 Core Coordination Logic
Construction schedule defines daily demand
Mixing plant adjusts production plans accordingly
Dispatch system updates output in real time
Each section receives materials based on priority and progress
📌 Key Functions
Align production capacity with construction milestones
Reduce idle production and material backlog
Improve supply stability across multiple sections
Support EPC-level integrated project management
👉 Core value: Production and construction operate in a synchronized loop.


Transport Fleet Route Optimization and Real-Time Dispatching
Transport is a critical link in asphalt supply. Digital systems optimize routing and vehicle allocation in real time.
🚛 System Functions
Dynamic route planning based on traffic and distance
Real-time vehicle tracking and status monitoring
Automatic dispatch based on section demand
Load balancing across multiple transport fleets
📊 Operational Improvements
Reduced waiting time at loading points
Lower empty return rates
Improved vehicle utilization efficiency
Faster response to urgent construction needs
👉 Core value: Logistics shift from static scheduling to dynamic optimization.
Temperature Monitoring and Real-Time Quality Tracking
Asphalt quality is highly sensitive to temperature and timing. Digital monitoring ensures quality stability from plant to paving site.
🌡 Monitoring System Coverage
Mixing temperature at production stage
Insulation status during transport
Arrival temperature at construction site
Real-time paving condition feedback
⚠ Key Quality Control Points
Temperature loss control within acceptable range
Immediate alerts for abnormal cooling
Traceable quality records for each batch
Reduced human error in quality inspection
👉 Core value: End-to-end visibility of asphalt quality lifecycle.

Data-Driven Supply Forecasting and Optimization Model
Modern asphalt supply systems rely on data analytics to predict demand and optimize resource allocation.
📈 Data Inputs
Historical construction progress data
Daily consumption rates per section
Weather and seasonal factors
Equipment utilization patterns
Transport efficiency records
🧠 System Outputs
Demand forecasting for each construction section
Optimal production scheduling plans
Transport resource allocation suggestions
Peak demand early warning signals
📊 Optimization Results
Improved supply-demand matching accuracy
Reduced material waste and idle capacity
Better planning for peak construction periods
Enhanced overall system efficiency
👉 Core value: From reactive management to predictive supply control.
A unified asphalt supply system depends on digital coordination across all stages:
Production planning aligned with construction progress.
Intelligent transport dispatch and route optimization.
Real-time temperature and quality tracking.
Data-driven forecasting and system optimization.
Its core transformation is: From fragmented manual coordination to an integrated, data-driven, real-time supply management system.
Cost Control and Construction Efficiency Optimization Pathways
In multi-section highway projects, the goal of asphalt supply optimization is no longer limited to “ensuring material delivery.” It now focuses on cost minimization, efficiency maximization, and full-chain coordination. Global engineering practice shows that a unified asphalt supply system can significantly improve performance across production, transportation, and construction stages.

Economies of Scale from Centralized Production
In large global infrastructure projects, centralized asphalt mixing plants have become a key approach to reducing unit costs.
📊 Cost Comparison: Distributed vs Centralized Production
| Cost Factor | Distributed Production | Centralized Production | Improvement |
|---|---|---|---|
| Unit production cost | Baseline (100%) | 70–85% | ↓15–30% |
| Energy consumption | High | Medium-low | ↓10–20% |
| Raw material loss | 5–10% | 2–5% | ↓50% |
| Labor cost | High (multi-site) | Centralized | ↓20–35% |
📌 Key Cost Drivers
Bulk procurement reduces raw material costs.
Fewer duplicated facilities reduce capital investment.
Automation reduces operational errors.
Centralized management simplifies operations.
👉 Core conclusion: Production centralization is the main driver of unit cost reduction.
Transport Distance Optimization and Material Loss Control
In multi-section projects, transportation is one of the most volatile cost factors. Asphalt is highly temperature-sensitive, making transport distance a critical control variable.
🚚 Key Global Transport Performance Data
| Indicator | Before (Distributed) | After (Unified System) | Improvement |
|---|---|---|---|
| Average transport distance | 30–60 km | 15–35 km | ↓20–40% |
| Temperature loss | 10–25°C | 5–12°C | ↓50%+ |
| Material loss rate | 6–12% | 2–5% | ↓50–60% |
| Empty return rate | 10–18% | 4–8% | ↓40–60% |
⚠ Optimization Methods
🏭 Central asphalt plant + auxiliary plant layout to shorten transport radius
🛣 GPS-based dynamic route optimization
🚛 Cyclic dispatching to reduce empty returns
🌡 Thermal-insulated transport systems to reduce heat loss
👉 Core logic: Transport distance is a key variable in material loss control.
Equipment Utilization Improvement Strategy
In traditional decentralized systems, equipment utilization is relatively low. Unified supply systems significantly improve operational efficiency.
📊 Equipment Utilization Comparison
| System Type | Utilization Level | Main Issues |
|---|---|---|
| Distributed supply system | 60–75% | Waiting time, scheduling conflicts |
| Semi-unified system | 75–85% | Partial optimization |
| Unified supply system | 85–95% | Continuous efficient operation |
📌 Key Mechanisms for Improvement
⏱ Unified production scheduling reduces idle time
📡 Real-time dispatch reduces waiting and conflicts
🚛 Synchronized transport and construction flow
🧩 Dynamic allocation across multiple sections
👉 Core logic: Utilization improvement comes from system coordination, not individual equipment performance.
Efficiency Gains in Multi-Section Parallel Construction
In multi-section highway projects, overall efficiency depends on network coordination rather than individual section performance.
🏗 Key Efficiency Drivers
Synchronization of material supply across sections
Capacity matching of asphalt plants
Transport responsiveness
Dispatch system coordination capability
📊 Global Engineering Efficiency Improvements
| Indicator | Before Optimization | After Optimization | Improvement |
|---|---|---|---|
| Schedule delay rate | High | Significantly reduced | ↓20–40% |
| Waiting time between sections | Frequent | Greatly reduced | ↓30–60% |
| Equipment idle rate | 20–35% | 5–10% | ↓Significant |
| Overall construction efficiency | Baseline | Improved | ↑15–35% |
⚠ Core Mechanisms
🔗 Unified dispatch reduces resource conflicts
🏭 Central asphalt plant ensures stable supply
🚛 Transport system optimizes dynamic routing
📡 Data-driven synchronization of construction rhythm
👉 Core logic: Multi-section efficiency comes from system coordination, not single-point optimization.
In multi-section highway projects, cost and efficiency optimization rely on four key system pathways: centralized production + transport optimization + utilization improvement + multi-section coordination
Industry Trends and Integrated Solution Development
Driven by continuous growth in global infrastructure investment, highway construction is entering a new stage of multi-section coordination, digital supply, and low-carbon construction. The industry is shifting from a traditional equipment-driven model to a system-efficiency-driven model, and the structure of asphalt supply systems is undergoing fundamental transformation.

Application Trends of Intelligent Asphalt Plants in Multi-Section Projects
Global asphalt mixing plants are rapidly upgrading toward automation and data-driven operation. The key improvements are higher precision, higher efficiency, and stronger stability.
📊 Smart Upgrade Performance Comparison (Global Engineering Data)
| Indicator | Traditional Plant | Smart Plant | Improvement |
|---|---|---|---|
| Mix ratio accuracy | ±2–5% | ±0.5–1% | ↓60–80% |
| Automation level | 40–60% | 80–95% | ↑35–55% |
| Production response time | 20–40 min | 5–15 min | ↓50–70% |
| Equipment utilization | 65–75% | 85–95% | ↑20–30% |
| Failure shutdown rate | 5–10% | 1–3% | ↓60–70% |
🧠 System-Level Impact of Upgrades
AI batching systems reduce human error by 70%+
Remote dispatch reduces on-site intervention by 40–60%
Predictive maintenance cuts downtime by 30–50%
Multi-plant coordination improves efficiency by 25–40%
👉 Core trend: Asphalt batch plants are evolving from mechanical equipment into data-driven production nodes.
Green Low-Carbon Construction and Recycled Asphalt Development
Driven by global carbon neutrality policies (EU, China, and Middle East infrastructure projects increasingly enforce low-carbon standards), the asphalt industry has become a key emission reduction sector.
🌍 Global Green Asphalt Technology Adoption
| Technology | Adoption Rate (2026 Trend) | Carbon Reduction | Cost Impact |
|---|---|---|---|
| Recycled Asphalt (RAP 20–50%) | 60–75% of projects | ↓15–35% | ↓8–20% |
| Warm Mix Asphalt (WMA) | 40–60% | ↓10–25% | ↓5–15% |
| Low-energy combustion systems | 50%+ new projects | ↓10–18% | ↓3–10% |
| Carbon monitoring systems | 30–45% | Trackable optimization | Higher management cost |
♻ System-Level Benefits
Material cost reduction: 8–20%
Energy consumption reduction: 10–25%
Carbon emissions reduction: 15–35%
Policy compliance rate: 90%+
👉 Core trend: Green asphalt production is shifting from optional technology to mandatory project standard.
EPC-Based Integrated Supply Solutions (System Integration Trend)
The EPC model is driving asphalt supply systems from equipment procurement to full system delivery. The key shift is significantly higher system integration.
📊 Evolution of EPC Supply Models
| Model | Trend Share | System Feature | Cost Structure |
|---|---|---|---|
| Decentralized procurement | Declining | Independent suppliers | High volatility |
| Single-equipment purchase | Gradually decreasing | Partial optimization | Limited efficiency |
| Integrated system model | 65–80% of new projects | Full-chain coordination | Controlled cost |
🔗 Core Integrated System Structure
🏭 Central asphalt mixing plant (core capacity)
🚛 Multi-section transport network (dynamic dispatch)
📡 Digital management platform (AI scheduling)
📊 Quality and cost monitoring system
📊 EPC System-Level Benefits (Average Global Data)
Project duration: ↓10–25%
Total cost: ↓12–30%
Equipment utilization: ↑20–35%
Supply interruption rate: ↓40–60%
👉 Core trend: EPC is transforming supply chains into integrated engineering delivery systems.

Application Value of AIMIX Asphalt Plants in Global Multi-Section Projects
In global multi-section highway projects, asphalt supply is shifting from standalone equipment to integrated system solutions. In this transformation, AIMIX asphalt mixing plants are increasingly used as core production nodes in unified supply systems rather than isolated machines. With global infrastructure investment exceeding, large EPC projects widely adopt a structure of central asphalt plant + multi-section coverage + intelligent dispatch systems, and AIMIX equipment fits well with this system model.
🌍 System Adaptability in Multi-Section Projects
In real engineering applications, AIMIX asphalt plants typically serve as core units in centralized supply systems. Their adaptability is reflected in the following aspects:
- Capacity range: 40–400+ TPH
- Service radius: 30–80 km engineering coverage
- System integration: compatible with GPS dispatch and digital platforms
- Deployment mode: hybrid of fixed asphalt plants + portable asphalt plants
📊 Real Engineering Performance in Multi-Section Projects
In multiple cross-regional highway projects, combining unified supply systems with AIMIX hot mix asphalt plants has achieved the following improvements:
| Indicator | Before (Decentralized Supply) | With AIMIX Unified System | Improvement |
|---|---|---|---|
| Asphalt quality consistency | High fluctuation | Stable and controllable | ↑30–50% |
| Equipment utilization | 60–75% | 85–95% | ↑20–35% |
| Transport efficiency | Low and scattered | Centralized optimization | ↑15–25% |
| Construction continuity | Frequent interruptions | Stable continuity | ↑25–40% |
| Total construction cost | High | Significantly reduced | ↓10–25% |
🧩 Role Positioning in Unified Asphalt Supply Systems
In modern multi-section highway projects, AIMIX asphalt plants are no longer used as standalone equipment. They are embedded into the overall system architecture:
The global asphalt industry is undergoing three major structural transformations:
Intelligentization (precision improvement 60%+).
Green low-carbon development (emission reduction 15–35%).
EPC system integration (65–80% adoption in new projects).
👉 Core future trend: Competition is shifting from “equipment efficiency” to “system coordination efficiency”.
Toward Unified Asphalt Supply: Making Multi-Section Projects More Controllable
With the rapid growth of multi-section highway construction worldwide, asphalt supply is shifting from decentralized delivery to centralized production, digital dispatch, and system coordination. Traditional models can no longer meet EPC project requirements for quality consistency, transport efficiency, and capacity matching. A unified asphalt supply system ensures stable, continuous, and predictable material supply for each section, reducing cost fluctuations and construction risks.
🚀 Get a Customized Multi-Section Asphalt Solution
If your project is facing:
- Unstable asphalt supply across multiple sections.
- Long transport distances and high temperature loss.
- Mismatch between capacity and construction progress.
- Low equipment utilization and uncontrolled costs.
We can provide a customized asphalt mixing plant system based on your project scale, section layout, and construction schedule. 👉 Build a more stable and efficient asphalt supply system for every highway project.
